Operation of Kuching Centralised Sewage Treatment Plant
Kuching Centralised Sewage Treatment Plant
CONSTRUCTION INFORMATIONS
(See details)
SYSTEM COVERAGE
Kuching Centralised Wastewater Management System Package 1 (64,501 PE)
Kuching Centralised Wastewater Management System Package 2 (22,048 PE)
Kuching Centralised Wastewater Management System Zone 1 Package 2 - Darul Hana (2,930 PE)
Private Development Connection (13,090 PE)
1. Sewer Plan Submission Status
Total connected to Kuching Centralised Wastewater Management System as at 31 March 2024 (102,569 PE)

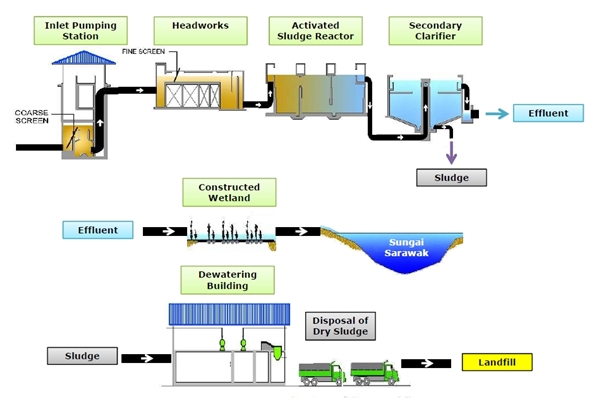

TREATMENT METHOD
EFFLUENT STANDARD
Point of Monitoring:
At Effluent Chamber after Secondary Clarifiers (See details)
Effluent Standard Monitoring
2017 | 2018 | 2019 | 2020 | 2021 | 2022 | 2023 | 2024
OPERATOR'S DETAIL
Agency | Sewerage Services Department Sarawak |
Focal Person/Plant Manager | Mdm. Amy Amen Anak Johnicol Linggang |
Commencement Date | 1 January 2017 |
Plant Hotline | 082-330194 |
TREATED VOLUME
Year | Summary | |
Influent Volume (m3) | Dry Sludge Volume (tonne) | |
2017 | 3,914,263 | 274.63 |
2018 | 4,213,344 | 445.22 |
2019 | 4,447,817 | 928.86 |
2020 | 4,353,198 | 381.55 |
2021 | 4,767,929 | 518.58 |
2022 | 2,970,272 | 264.12 |
2023 | 4,712,878 | 711.1 |
Detail Treated Volume (2024)
Treatment Process | Jan | Feb | Mar | Apr | May | Jun | Jul | Aug | Sept | Oct | Nov | Dec |
Influent Volume (m3) |
543,919 |
496,456 |
522,650 |
|
|
|
|
|
|
|
|
|
Dry Sludge Volume (tonne) |
66.42 |
11.5 |
47.39 |
|
|
|
|
|
|
|
